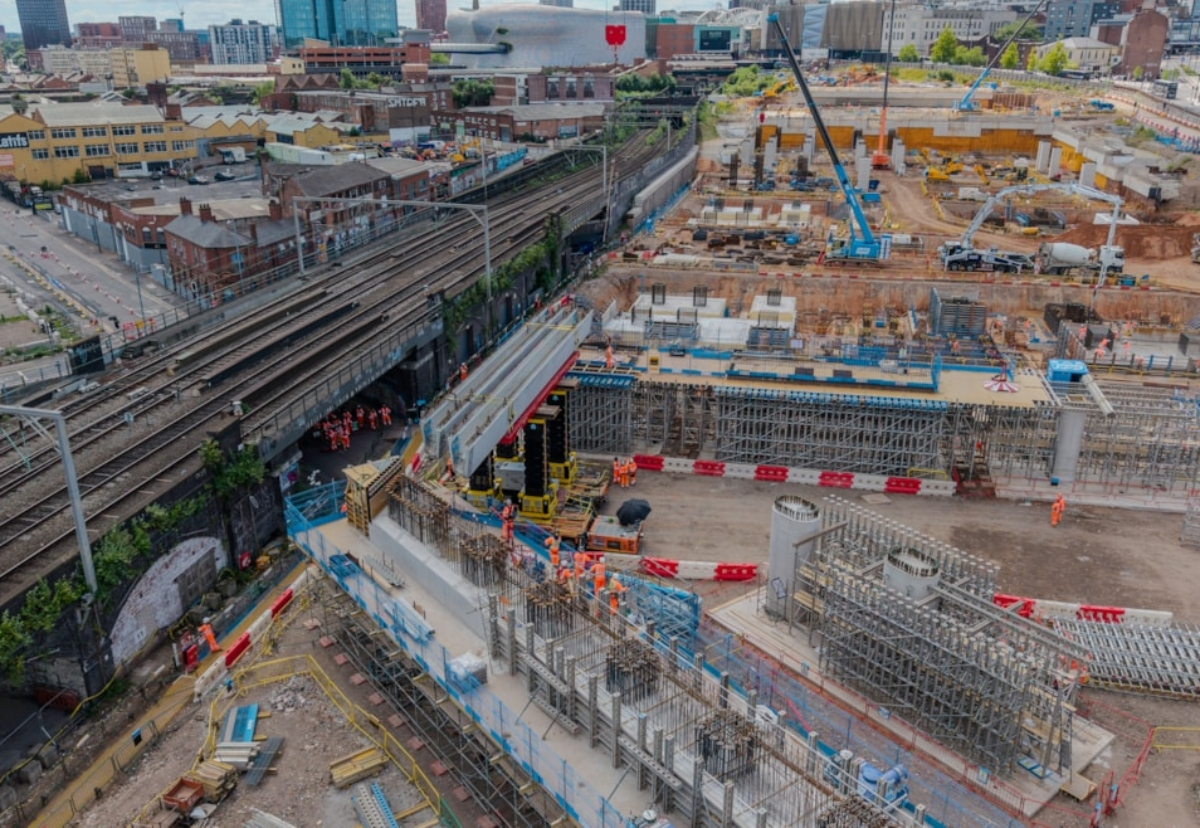

HS2 reset faces contractor and Euston tests

HS2 reset faces contractor and Euston tests

HS2’s reset still depends on contractor deals and Euston funding. Cost control, delivery governance, and commercial discipline remain central to the programme.


IN Brief:

  • HS2’s reset is expected to continue into spring 2027 after starting in January 2025.
  • Contractor negotiations, commercial controls, organisational capability, and Euston delivery remain unresolved pressure points.
  • The programme continues to carry major cost exposure, with further public funding expected for Euston.

HS2 Ltd is moving through a critical phase of its programme reset, with contractor negotiations, commercial controls, and the future of Euston still shaping the delivery outlook for Britain’s largest infrastructure project.

The reset began in January 2025 and is expected to continue until spring 2027. Its workstreams cover cost and schedule, supply-chain and commercial arrangements, organisational capability and culture, and programme governance across a scheme that has already absorbed substantial public spending.

By the end of March 2026, the Department for Transport and HS2 had spent £46.8bn on the programme, including expenditure linked to cancelled Phase 2 elements. The Department for Transport’s current cost range for Phase 1 stands at £87.7bn to £102.7bn.

The reset is intended to establish a more credible baseline and reduce the risk of further cost escalation. Contractor negotiations remain one of the most difficult parts of that process, particularly as HS2 has identified hundreds of millions of pounds of disallowable contractor costs and continues to work through revised commercial arrangements.

Reaching new agreements with the supply chain is only part of the challenge. The commercial reset must also change how packages are managed on site, how risk is recorded, how decisions are escalated, and how delivery performance is measured. Without those changes, revised contracts can become another layer of paperwork over the same underlying problems.

Euston remains a separate but connected test. The Euston Delivery Company was established in April 2026 to take forward the station and wider development programme, yet the route to a fully funded, buildable plan is still being settled. Further public funding is expected on top of money already spent, keeping the station at the centre of political and commercial risk.

Delivery pressures are not confined to budgets and baselines. Major works of this scale carry constant safety, logistics, and supervision demands, with regulatory action over a tipper truck incident showing how quickly site management failures can become legal and financial issues alongside programme risk.

The construction challenge is now as organisational as it is technical. HS2 brings together long chains of contractors, designers, specialist suppliers, utilities interfaces, land constraints, railway systems, tunnelling works, and station delivery. Resetting that kind of programme requires a contracting model that gives delivery partners enough certainty to plan while giving the client enough control over cost and performance.

Across the wider infrastructure market, that balance has become harder to strike. Public clients need affordability and auditability, contractors are guarding against excessive fixed-price exposure, and specialist suppliers are selective about where they commit capacity. On megaprojects, unclear risk allocation can quickly turn into slower delivery, higher claims activity, and weaker commercial trust.

HS2’s experience is likely to influence future procurement. Large infrastructure clients are expected to demand stronger early-stage cost assurance, clearer gateway controls, and more realistic treatment of design maturity before construction commitments are made. Contractors, in turn, will push for deeper preconstruction involvement and more transparent treatment of risk before prices are locked down.

Euston adds further complexity because it combines railway infrastructure with development, public realm, station operations, utilities, and funding structures. The station cannot be treated as a conventional civil engineering package. Its affordability depends on engineering, property, political, and operational decisions holding together over several years.

The reset gives HS2 a route to rebuild confidence, but its value will be judged by delivery behaviour rather than revised governance language. Contractor agreements, stronger controls, and a credible Euston plan now have to translate into firmer decisions, clearer accountability, and more predictable progress on the ground.
